Preparing the doorway correctly is essential for a safe, precise, and seamless lift installation. Every opening must match the signed Lift Shop Final Drawing and be built to withstand structural loads, align with finished floors, and suit the final wall finishes. This guide outlines everything your builder needs to prepare before our installers arrive.

For more detailed planning information, download our Builder's Guide.

Download our Builder's Guide →
Luxury swing lift door
01 · The Opening

Door Opening Dimensions

Each door opening must be built exactly to the approved Lift Shop drawing. All openings must be square, level, and plumb from floor to ceiling.

  • Confirm finished floor levels match the approved design and signed Final Drawing.
  • Allow for internal finishes such as render, sheeting, or tiles.
  • Keep reveals clear of conduits, wiring, or plumbing.
  • Ensure full height and width as shown on your final layout drawings.
  • Maintain uniform openings across all floors.

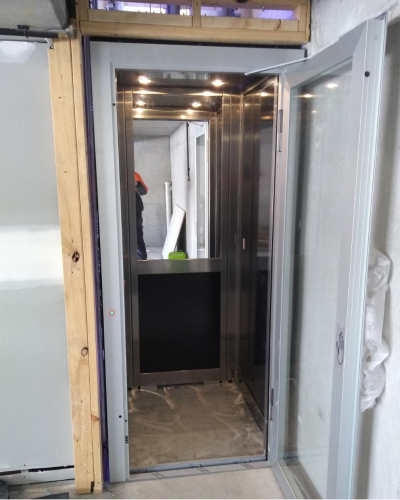

Lift door installed in a framed opening with the header detail above
02 · Support

Structural Support

Lift doors are anchored directly to the building structure. Solid supports must be in place before installation.

  • Provide continuous masonry or timber backing above and below every doorway to support the door rack, sill, and header mechanism.
  • Reinforce hinge and strike sides with solid blocking.
  • Extend supports at least 100 mm beyond the door opening for secure fixing.
  • Keep framing exposed until after lift installation; do not sheet, tile, or render these areas prematurely.

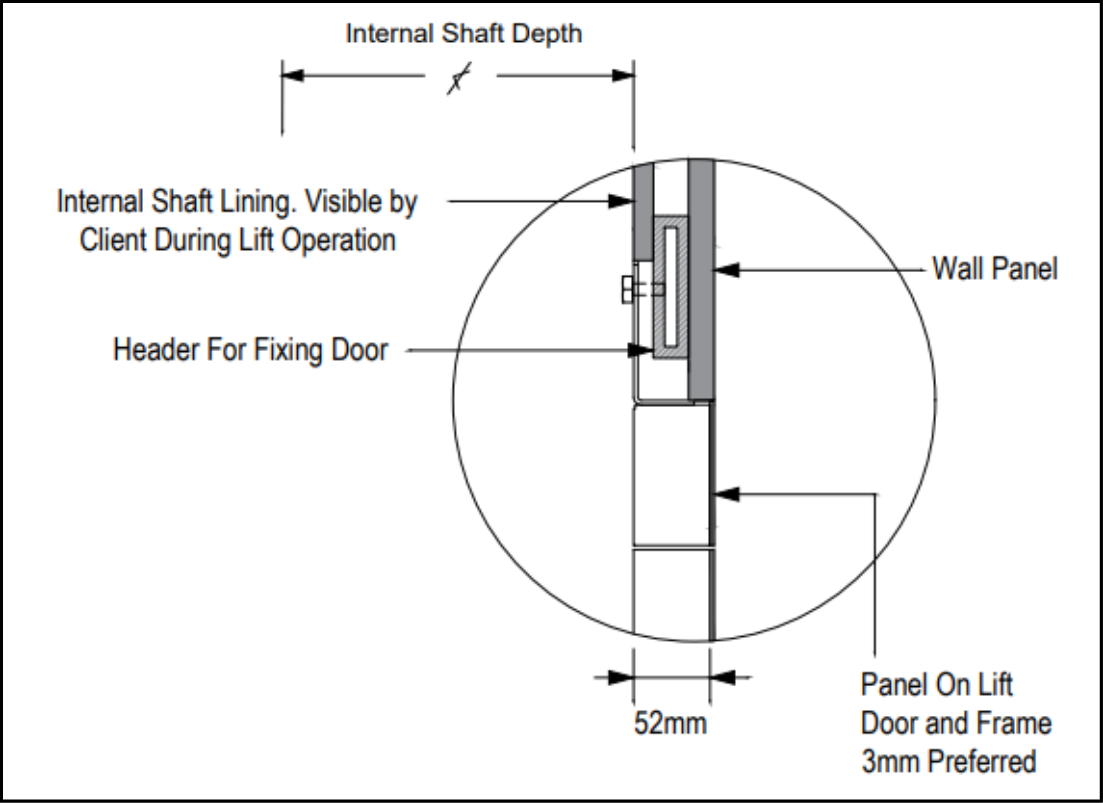

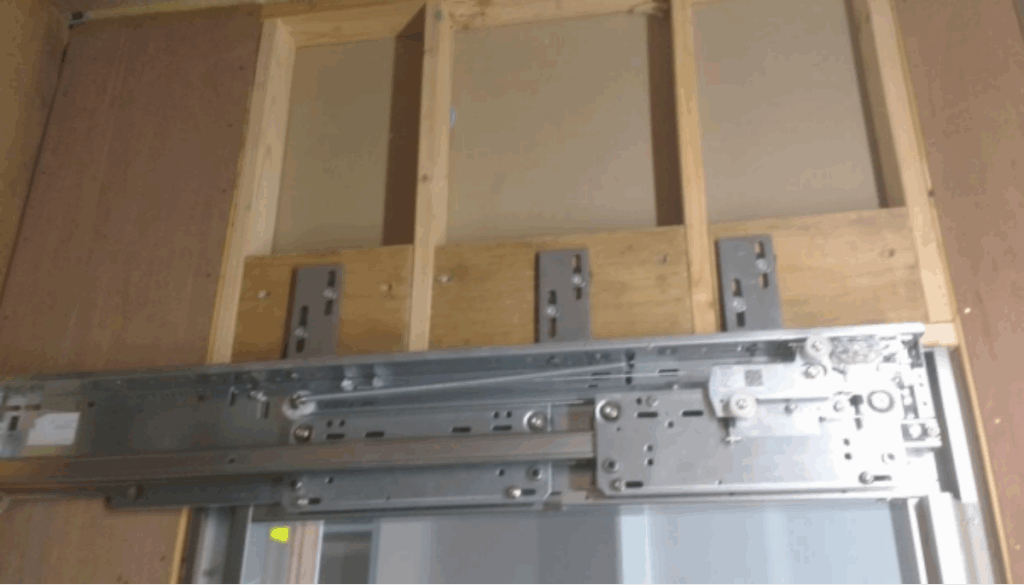

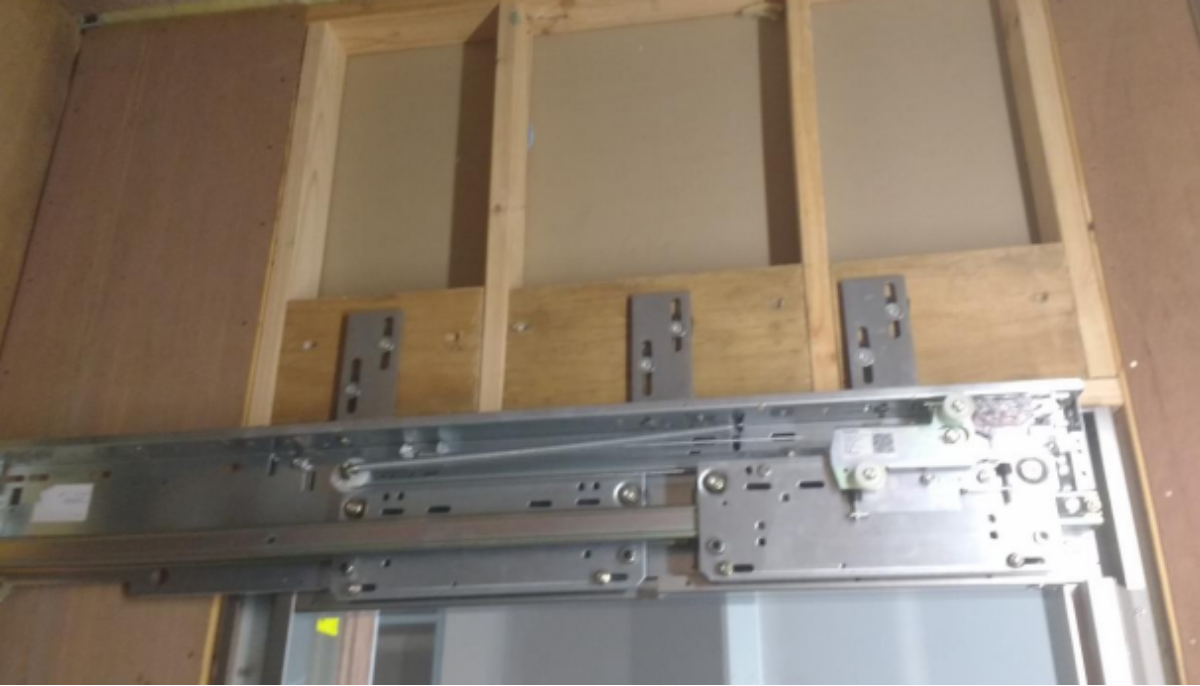

Lift door support and fixing points on masonry and timber backing
03 · Cladding

Door Cladding and Wall Alignment

Builders can finish doors to blend seamlessly with the wall or joinery. Follow these limits to ensure smooth operation and long-term reliability.

  • Wall thickness must match door thickness (typically 55 mm).
  • Maximum cladding thickness 5 mm (3 mm preferred).
  • Maximum total door panel weight 10 kg.
  • Fix using adhesive, nails, or screws only.
  • Cladding must allow full door swing and not restrict hinge movement.
  • On the hinge side, reduce or omit cladding to maintain clearance.
  • Maintain access to the emergency keyhole and call button at all times.
  • Avoid dense or heavy decorative materials that could cause sagging or binding.

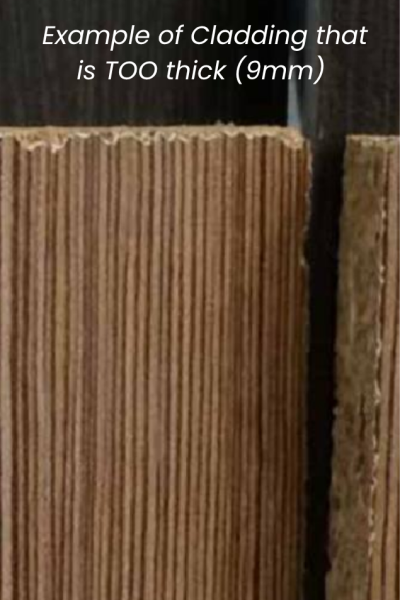

Example of incorrect 9mm door cladding causing hinge binding
04 · Buttons & Keys

Call Button and Key Access

Each landing includes a call button plate and emergency key access point. Space and access must be left clear for these components.

  • Cut call button openings only after door installation for a precise fit.
  • Leave a maximum of 3 mm material thickness behind the button plate.
  • Do not conceal electrical conduits behind finished panels.
  • Keep emergency keyholes visible and unobstructed for service access.
  • Coordinate with Lift Shop installers before framing or cutting around button zones.

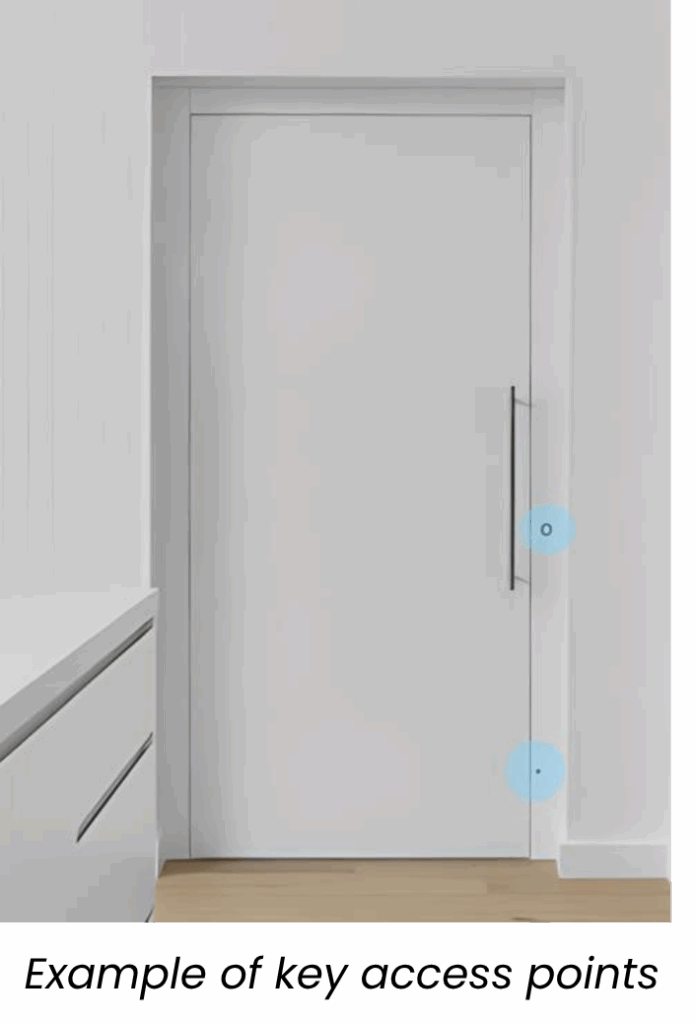

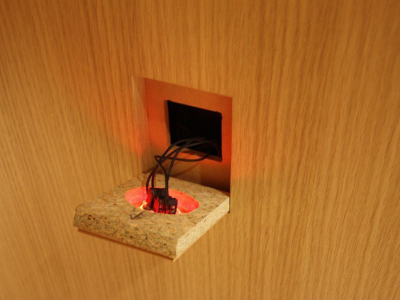

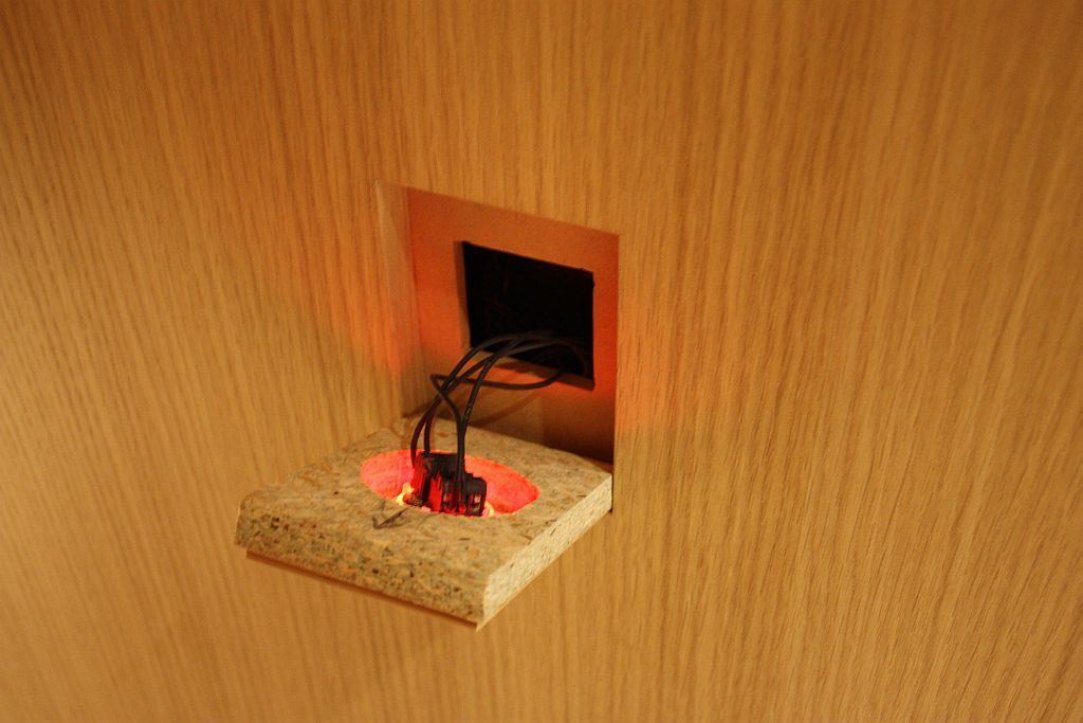

Lift door key access point and call button layout

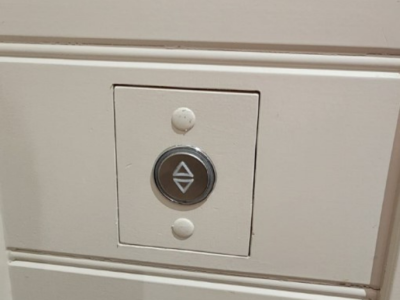

Examples of Custom Button Plates by Client

Custom lift call button plate on a landing door Custom lift call button plate prepared in a finished wall Custom lift call button plate beside a landing door
05 · Finishes

Gaps, Clearances and Finishes

Correct spacing and alignment ensure reliable performance and a clean finish.

ComponentRequirementNote
Door swing clearanceDoor must open freely without obstructionCheck before final cladding
Floor-to-sill transitionNo lip or step beyond the tolerance for your liftBuilder to level to FFL
Wall alignmentConsistent wall depth and finish thicknessMatch across every floor
Between-door wallsLine and finish visible shaft surfacesVisible during lift operation
Shaft revealNo services or recessesSmooth and flush for sealing

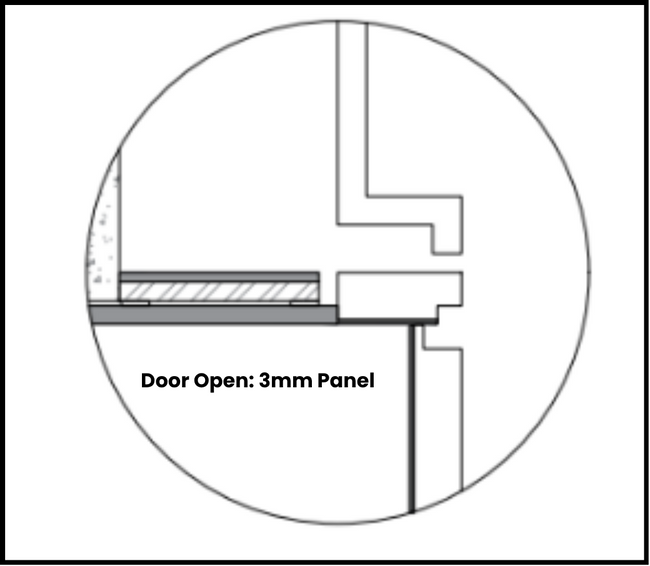

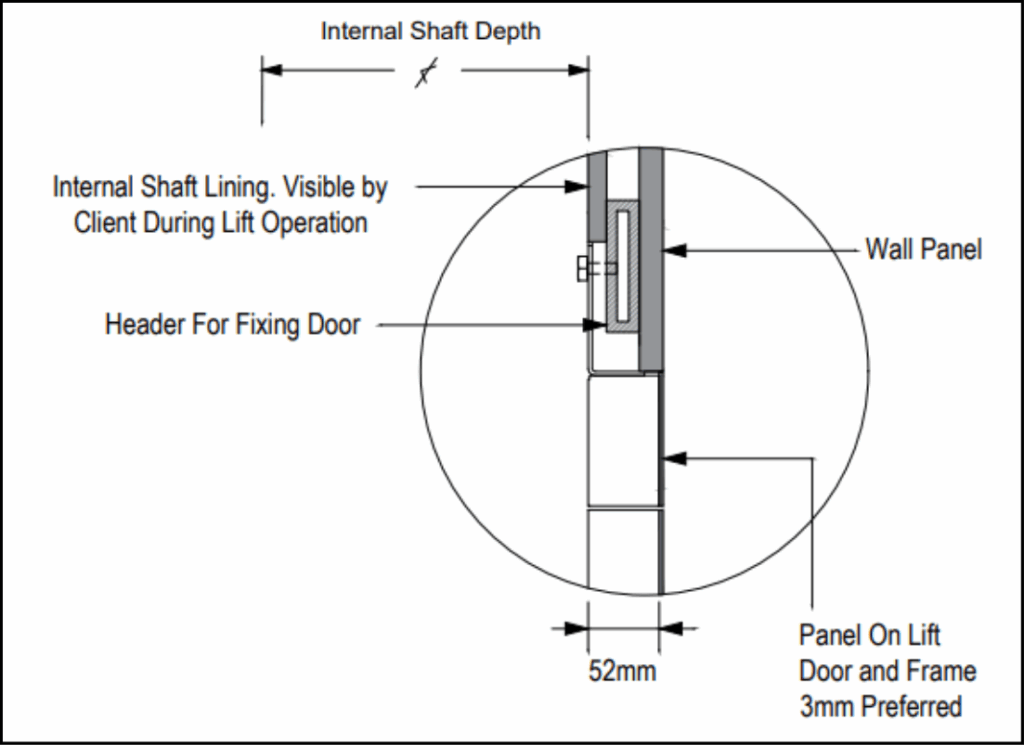

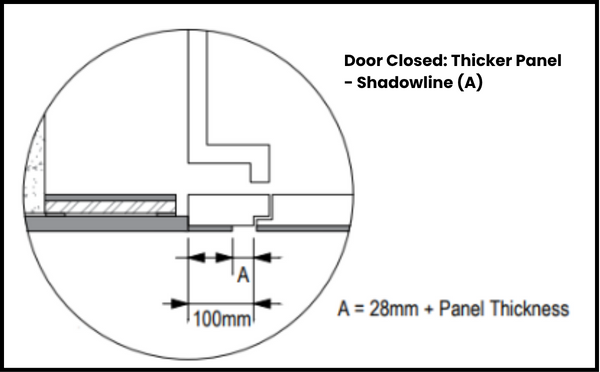

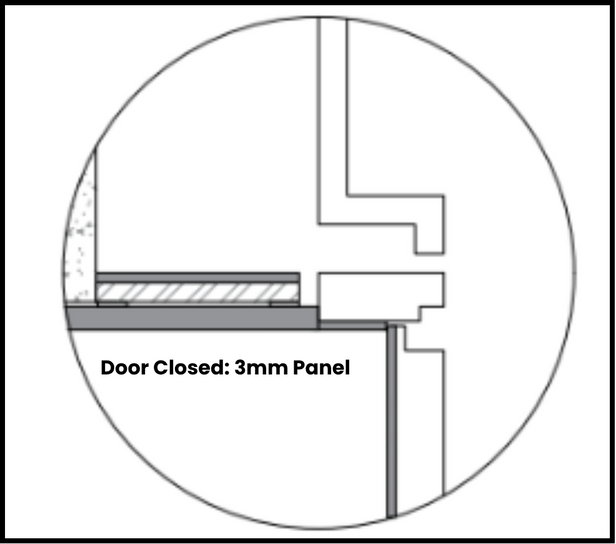

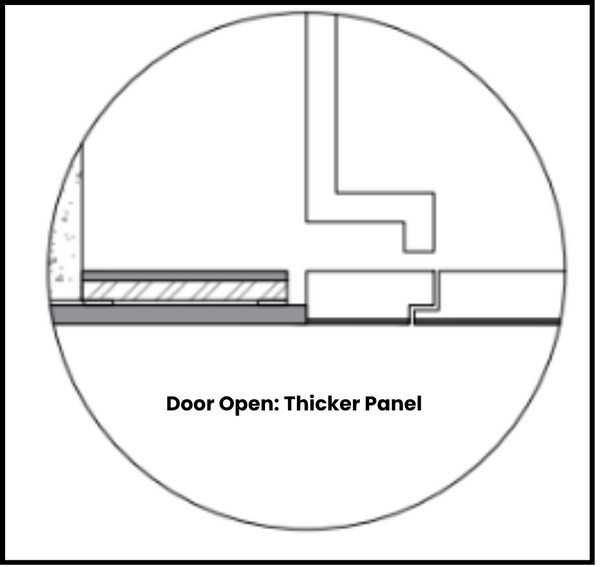

Plan drawing of a wall panel lift door detail showing integrated panel and wall panel thickness Lift door detail drawing for installation Integrated flush lift door detail drawing Landing door final touches detail Landing door final touches detail Landing door final touches detail Landing door final touches detail

Drag or swipe to see more door details. Tap a drawing to enlarge.

06 · Before We Arrive

Final Builder Sign-Off

Before Lift Shop installation, confirm all site conditions meet the approved drawings and requirements:

  • All openings framed and supported per final Lift Shop drawings.
  • Wall finishes stop flush with the shaft wall edge.
  • Floor finishes completed to final level.
  • Temporary coverings removed and work area clean.

Once installation starts, no further structural or finishing changes can be made without Lift Shop approval.

07 · Premium Finish

Optional Design Integration

For a premium finish, consider:

Wall-clad or panelled doors that blend into surrounding joinery.
Minimalist trims or flush finishes for a concealed look.
Colour-matched door frames and button plates for design continuity.

Lift Shop can guide your builder or designer on suitable materials and tolerances before work begins.

Lift Shop A Series cabin with premium finishes in Gladesville home
Glass-floored walkway beside a glass Lift Shop home lift shaft and white spiral stair, ocean view
For Builders

Download Builder's Guide

Practical lift planning guidance for builders and project teams, covering shaft requirements, door preparation and key considerations before construction.

Door Preparation FAQs

What are the most common door-prep mistakes that delay installation?

The most frequent mistakes are incorrect door opening dimensions (too small or too large), inadequate backing support behind cladding or panels, cladding that prevents full door swing, and button box openings cut before the door is installed. We also see undersized framing that sags under load, wall finishes applied before the lift is fitted (which then prevents proper sealing), and electrical conduits drilled through wall thickness without engineer approval. Following our detailed door preparation guide carefully eliminates most delays. We provide a final drawing for sign-off showing all critical measurements, and we recommend your builder reference this before any finishing work begins.

What are the correct door opening dimensions for a Lift Shop lift?

Door opening dimensions depend on your chosen lift series and door type (swing or sliding). We provide detailed engineering drawings showing the exact opening dimensions required for your specific configuration during the design phase. These dimensions must be accurate to within plus or minus 5 mm (+/-5 mm) to ensure the doors align properly and operate smoothly. The wall thickness must match the door thickness (typically 55 mm for standard installations). We work closely with your builder to confirm all opening dimensions before any structural work begins, and we recommend a final dimensional check on site before finishing.

How thick can lift door cladding be?

Cladding material applied to lift door frames must not exceed 5 mm thickness, with 3 mm being our preferred maximum. Thicker cladding can interfere with door sealing, alignment, and operation. Common cladding materials include timber veneer, engineered wood, laminate, or composite materials. All cladding must be applied using approved adhesive, nails, or screws without penetrating through to the other side. On the hinge side, reduce or omit cladding for adequate door swing clearance. We provide detailed guidance on how to prepare the door frame and apply cladding correctly to stay within tolerance.

How do I prepare door openings for a flush 'hotel-style' finish?

A flush hotel-style finish means the lift door frame sits level with the surrounding wall, with no gaps or offset. To achieve this, ensure the door opening is constructed with continuous, level backing on all sides (typically 190 mm solid blockwork extending 100 mm beyond the opening above and below). Cladding must be carefully aligned so the finished surface is flush and level. After the door is installed, your joiner can apply matching finishes (paint, veneer, or panels) over the entire wall area around the door, creating a seamless aesthetic. We provide guidance on frame preparation and recommend coordination between our team and your joiner to ensure proper alignment before any finishing work begins.

Can my joiner/cladder wrap lift doors to match surrounding cabinetry?

Yes. Your joiner or cladder can wrap the lift door frame with matching timber veneer, laminate, or other materials to create a seamless integration with surrounding cabinetry and finishes. This creates a bespoke, built-in appearance. The key requirement is that cladding thickness does not exceed 5 mm (3 mm preferred), and it must not interfere with door operation, sealing, or alignment. After the lift is installed and operational, we can advise your joiner on safe cladding techniques and material placement. We recommend involving your joiner early in the design phase so we can factor cladding into the door frame preparation and opening dimensions.

When should the builder cut the call button opening?

The call button opening must be cut only after the lift door is installed and the frame is fully secured. Cutting the opening before installation can create structural weakness or misalignment. The call button is typically positioned approximately 900 mm above the finished floor level (FFL), on the side near the door handle, for convenient reach. After the door is installed, we mark the exact button opening location and your builder cuts the opening to our specification. Maximum material thickness behind the button plate must be 3 mm. The builder then grooms and finishes the button box surrounds to match the surrounding wall.

What floor lip/threshold is acceptable at the sill?

The lift sill should be level with the surrounding finished floor level (FFL) within a tolerance that depends on the lift. An acceptable floor lip is minimal, ideally none. Any lip beyond that tolerance becomes an accessibility concern and a tripping hazard for all users. If the floors on either side of the doorway are at different levels due to building structure, we work with your builder to minimise the step. We measure the surrounding FFL during site assessment and provide guidance on how to achieve level sill alignment during construction.

Do you provide a final drawing for sign-off, and what counts as 'finished floor level'?

Yes. We provide a detailed final drawing showing all critical door opening dimensions, sill level, button placement, and cladding tolerances for your builder and building certifier to sign off before finishing work begins. This drawing is specific to your project and serves as the single source of truth for construction. Finished floor level (FFL) is the elevation of the completed floor surface after all flooring materials (tiles, timber, carpet, etc.) are installed. It does not include construction screed or substrate, only the final walking surface. We confirm FFL with your builder early in construction and reference it in all dimensional drawings to ensure consistency throughout the project.

What finishes must be completed before lift installation?

Before we install the lift, the following must be complete: the shaft must be constructed and certified as compliant, the door opening frame must be in place and dimensionally verified, all structural backing and wall finishes around the door must be complete, and the floor sill area must be finished to final level. Electrical power must be run to the lift location and tested. Any cladding or panel work around the door can proceed after installation, but the underlying structure must be solid and finished. Wall paint and final cosmetic finishes can occur after our installation, but we recommend they happen after testing to avoid damage. We work closely with your project manager to schedule installation at the optimal point in your build sequence.

The Showroom

The only way to judge a lift is to stand in one

Visit a Lift Shop showroom in Sydney, Melbourne, Brisbane or Perth (Canberra opening soon) and see the cabins, doors and glass options in person. We're also installing in Adelaide, the Gold Coast and the ACT. Lift Shop lifts are rated 5 stars by Australian customers and backed by an 8-year warranty.

4.9 ★★★★★Google Rating
6,500+ ★★★★★Five-Star Reviews
Inside the Lift Shop Sydney showroom at Pagewood, the world's largest home elevator display
Download Brochure
